Home  /  Commercial scaffolding

Commercial Scaffolding in Canberra

Scaffolding for apartment blocks, offices and government buildings in Canberra and Queanbeyan: facade access, hoists, covered gantries, shade mesh and the licence, inspection and public land rules that come with them.

What counts as commercial scaffolding

Commercial scaffolding is scaffolding on anything bigger than a house: apartment buildings, offices, shopfronts, schools, hospitals, and public and government buildings. The work done from it is facade repair, cladding and window replacement, painting, waterproofing, balcony remediation, roof plant and new construction. The scaffold itself is a different engineering job from a residential perimeter. It is taller, it carries more people and more material, it often has to protect a footpath and a street, and it is more likely to need a design and a plan. We are a referral service: we pass your enquiry to local licensed scaffolders and do not own scaffolds or do the work.

Canberra has the building stock for it. The ABS snapshot of the ACT in 2021 counted flats or apartments at 19.4% of dwellings, up from 15.0% in 2016, while separate houses fell from 67.0% to 63.2%. ACT Planning's district profiles show where the density is: higher density housing is 45% of South Canberra, 41% of North Canberra, 36% of the Molonglo Valley and 17% of Woden Valley. Those figures are dwelling mix, not a count of scaffolds, but they point to where body corporates and building managers are most likely to need facade access.

Scaffold types for larger buildings

Safe Work Australia's guide to scaffolds groups the types by how they are built. Most commercial work uses prefabricated scaffolds, which are modular systems of prefabricated components (operators often call modular steel Kwikstage), and tube and coupler scaffolds, built from tube and joining couplers and used where the shape of the building will not fit a standard bay. Birdcage scaffolds, which have more than two rows of standards in both directions, are used for working areas across a large footprint such as a stairwell or atrium. Hung and suspended scaffolds are used where the work cannot be reached from the ground. The types of scaffolding page sets out the definitions.

Which licence class covers which, as SafeWork NSW describes them, is worth knowing, because no ACT page lists the scopes. Basic scaffolding (SB) covers modular and prefabricated scaffolds, cantilevered materials hoists up to 500 kg, and bracket scaffolds. Intermediate scaffolding (SI) adds tube and coupler scaffolds, including covered ways and gantries, cantilevered and spurred scaffolds, perimeter safety screens and shutters, and mast climbers. Advanced scaffolding (SA) adds cantilevered hoists, hung scaffolds and suspended scaffolds. The ACT licensing pages name the classes, so ask the scaffolder which class the person building yours holds.

Commercial featureWhat it isWhat to ask
Facade accessA modular or tube and coupler scaffold up the face of the building, with working decks at each liftThe maximum height, number of decks and loading, and who inspects it
HoistA materials hoist, often at a corner, that lifts loads to the decksThe class of the erector and the hoist's rated load
Covered gantryA roofed walkway over the footpath so pedestrians pass below the workWho applies for public land approval and the traffic management plan
Shade mesh or sheetingMesh or sheet fixed to the scaffold to control dust, debris and sunHow the added wind load has been checked
Stair towerA stair access in place of ladders, for crews using the scaffold dailyWhere it lands and how it is protected at ground level
BirdcageA full-footprint platform inside a large space such as an atriumThe load the floor below can carry

Treat the table as a list of questions rather than a specification. The scaffolder and the project designer decide what a particular building needs.

Hoists, gantries and facade access in practice

A hoist on a commercial scaffold moves loads that would otherwise be carried up by hand. The SafeWork NSW page puts cantilevered materials hoists up to 500 kg in the SB scope and cantilevered hoists in the SA scope, so the class of the person who erects the hoist matters as much as the class of the one who builds the deck. A covered gantry over a footpath keeps people clear of falling objects, and the same page places covered ways and gantries in the SI scope. The 2017 WorkSafe ACT audit found that only one of the five commercial scaffolds checked was compliant for access openings, which are the gaps where people step on and off a deck. That audit is history, not a current statistic, but access openings, ladders and stairs are worth checking at every handover.

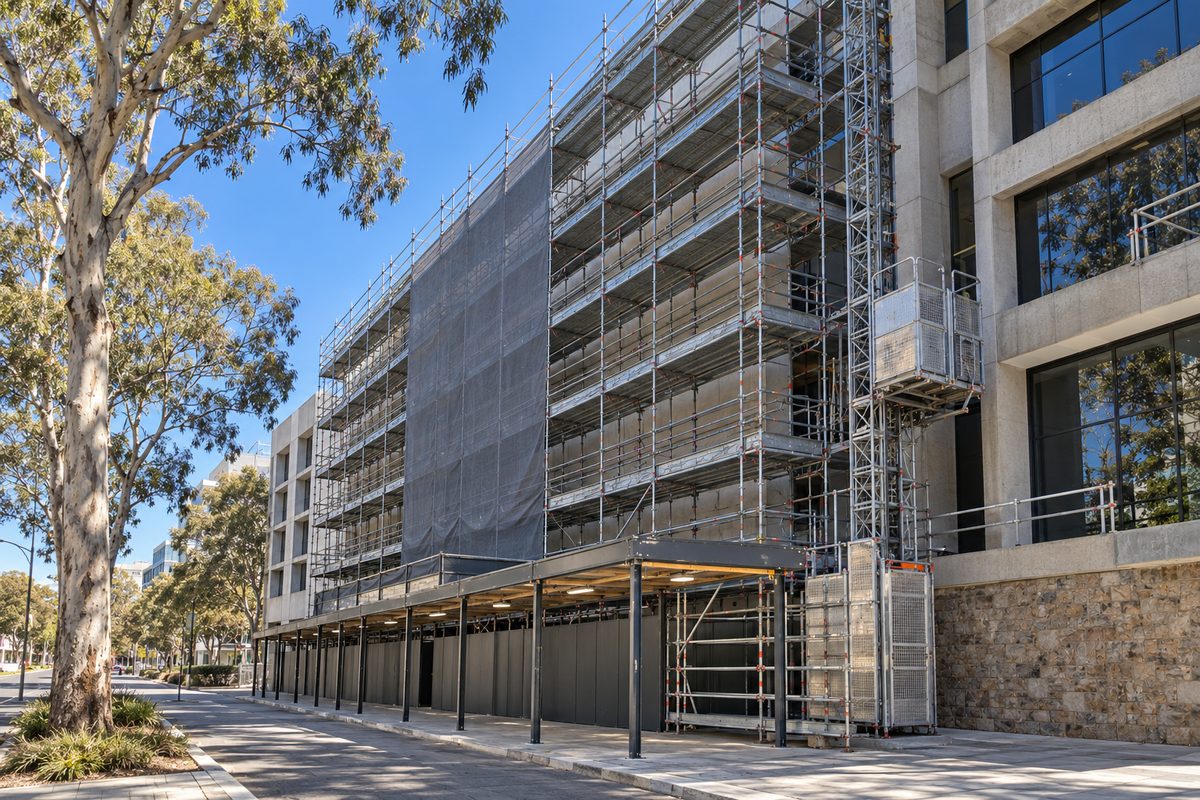

A mid-rise concrete and glass building with a tall steel scaffold up one facade, plain grey mesh on part of it, a hoist tower at the corner and a covered gantry over the footpath below, with street gum trees.
A mid-rise facade with hoist tower and covered gantry.

Facade work from a tall scaffold has a second problem, which is the building. Ties need to be taken back to the structure at points the scaffolder and the building owner agree, and the glass, render or cladding must not be damaged. For a building under strata, the committee or manager will need to approve fixings and the dates. For a government or heritage building, the owner will need to approve them as well. Ask who signs off the tie points before the quote is accepted.

Shade mesh, sheeting and wind

Sheeting or mesh on a scaffold catches wind, and the wind load goes into the scaffold and its ties. Safe Work Australia's information sheet on tower and mobile scaffolds says that height is limited by the manufacturer's base ratio and reduced if the scaffold is sheeted or wind-exposed, and says never to move a mobile scaffold in windy conditions. That sheet is about towers, not facade scaffolds, so use it as a reminder rather than a rule for your building. Ask the scaffolder who has checked the sheeted design, and what the plan is if a storm is forecast. WorkSafe ACT alerts say a scaffold should be inspected after an event affecting stability such as a severe storm, so a storm should trigger an inspection before anyone steps back on it.

The Bureau of Meteorology's Canberra Airport record (2008 to 2026) gives a mean annual rainfall of 636.7 mm, with December the wettest month at 75.2 mm. We do not publish wind statistics for Canberra beyond the two airport station values in the climate record, so wind assumptions belong to the scaffolder's design, not to this page.

On a tall facade the question is not what the scaffold is made of, but who has checked it, who inspects it, and who signs for it.

Duties, plans and handover

WorkSafe ACT says the WHS Act gives duties to designers, scaffolding contractors and workers carrying out scaffolding work, and to principal contractors for a construction project where the cost is $250,000 or more. Larger commercial jobs may cross that line. On such a project the principal contractor is a duty holder, and a body corporate or building manager should ask who that is. Safe Work Australia's inspection guide says a competent person must give written confirmation that construction is complete before a high-risk scaffold is used, and that a scaffold with a fall risk over 4 metres is inspected at least every 30 days.

Safe Work Australia's guide says a scaffolding plan should be prepared by a competent person for more complex scaffolds, kept at the workplace, and shown with a site layout plan and elevations and sections. That is guidance, not a verified ACT duty, but it is the sensible thing to ask for on a commercial job. Its example handover certificate lists the certificate number, the erector and client details, the drawings and intended use, the duty classification, the number of working decks, the top platform height, the bay types, the plant design registration number if applicable, a handover inspection statement with the inspector's name, signature, licence number, date and time, client acceptance, and an attached checklist. WorkSafe ACT names a written handover certificate for suspended scaffolds, and Safe Work Australia's guide gives the example above, so ask for one on any scaffold. The inspections and handover page goes into it.

Footpaths, hoardings and public land

A commercial scaffold on a street frontage often meets public land. In the ACT, the approval for works on or using public unleased land applies to works on or occupying unleased public land, with applications 14 working days before starting and a temporary traffic management plan possibly needed. The public unleased land permit covers activities that exclude the public, with a skip on a footpath as the listed example. Neither page names scaffolding or hoardings, so we cannot say what an ACT hoarding standard is, and we do not state one. Confirm with the Public Land Use Team (02 6205 8794). In Queanbeyan the consent for works on a footpath or road comes from the council under section 138 of the Roads Act 1993, and the border page explains how it differs.

Overhead lines matter on the street side. Evoenergy gives clearances for hoarded scaffold of 1.5 metres from low voltage and 2.0 metres from 11 kV to 22 kV lines horizontally, and 2.4 metres vertically, and says a safe work method statement is required. On a government or heritage building, check the ACT Heritage Register for the block, because the Heritage Council pages we read do not mention scaffolding, and ask before fixing anything to a registered place.

What a commercial page cannot do

It cannot design or approve a scaffold, and it cannot tell you what loads, ties, sheeting or hoists your building can take. It cannot say whether your project is over the $250,000 threshold, whether public land approval covers your hoarding, or whether your building is heritage listed. A competent person and the scaffolding contractor carry those decisions, not this page or us. Ask for the plan, the handover certificate, the licence classes and the inspection schedule in writing, and keep them with the building records.

Written October 2026

Check the current rules before you rely on this

This page describes how commercial scaffolding is licensed, inspected and approved for Canberra buildings. It describes the rules in general terms as they stood in October 2026. Standards, forms, thresholds and fines change.

The authoritative sources are Safe Work Australia, guide to scaffold inspection and maintenance, Safe Work Australia, guide to scaffolds and scaffolding work, WorkSafe ACT, scaffolding, SafeWork NSW, scaffolding licences, ABLIS, approval for works on or using public unleased land (ACT) and Evoenergy, scaffolding near overhead powerlines. Where anything here differs from those sources, they are right and we are not.

We are not scaffolders, engineers, regulators or lawyers. For what applies to your job, ask the scaffolding contractor, WorkSafe ACT (13 22 81) or, for work on public land, the ACT Government Public Land Use Team.

Accurate at the time of writing, October 2026. Always check the source before relying on it.

Questions

Common questions

What licence do commercial scaffolders need in the ACT?

A high risk work licence is needed to erect, alter or dismantle a scaffold from which a person or object could fall more than 4 metres. The classes are Basic (SB), Intermediate (SI) and Advanced (SA), issued through Access Canberra. As SafeWork NSW describes them, SB covers modular scaffolds, SI adds tube and coupler, covered ways and gantries, and SA adds hung and suspended scaffolds.

Who is responsible on a commercial scaffold job?

WorkSafe ACT says the WHS Act gives duties to designers, scaffolding contractors, workers and, on projects costing $250,000 or more, principal contractors. The person with management or control of the scaffold must make sure it is inspected and maintained. Ask who each of those parties is on your project before work starts.

Do hoists need a special licence?

As SafeWork NSW describes the classes, cantilevered materials hoists up to 500 kg fall within Basic scaffolding (SB) and cantilevered hoists within Advanced scaffolding (SA). No ACT page lists the scopes, so ask the scaffolder which class the person erecting the hoist holds, and ask Access Canberra if you want to confirm it.

Do I need approval to build a covered walkway over a footpath?

Likely, yes. In the ACT, works on or occupying public unleased land need approval, applied for 14 working days before starting, and a temporary traffic management plan may be needed. No ACT page we found names scaffolding or hoardings, so confirm with the Public Land Use Team on 02 6205 8794. In Queanbeyan, section 138 consent from the council applies.

What paperwork should I get when a commercial scaffold is handed over?

Safe Work Australia's guide says a competent person must give written confirmation that construction is complete before a high-risk scaffold is used, and gives an example certificate listing the erector, the top platform height, working decks, bay types and the inspector's licence number. WorkSafe ACT names a written certificate for suspended scaffolds, so ask for one on any scaffold.

How often should a commercial scaffold be inspected?

WorkSafe ACT alerts say before first use, after an event affecting stability such as a severe storm, before use after repairs, and at intervals not exceeding 30 days, by a competent person. Safe Work Australia's guide says a scaffold with a fall risk over 4 metres is inspected at least every 30 days. A scaffold tag should be present and show the inspection.

Can shade mesh be fitted to any scaffold?

Not automatically. Mesh and sheeting catch wind and add load to the scaffold and its ties. Safe Work Australia's tower sheet reduces permitted height for sheeted or wind-exposed towers, which is a reminder that sheeting changes the design. Ask the scaffolder who has checked the sheeted scaffold and what happens if a storm is forecast.

Does a heritage listing change how a government building is scaffolded?

It may. The ACT Heritage Council pages we read do not mention scaffolding or temporary works, so we cannot say how a scaffold is treated on a registered place. Check the ACT Heritage Register for the block and ask before fixing anything to a registered place, including tie points and anchors.
